Project management
| Production Deployment of the New Integrator Project Charter |
New Integrator (Production Deployment)
Initial / Project Charter
Copyright © 2001, 2002 Ford Motor Company
(U.S. and international notice, and original material were added in each indicated year.)
Contents Page
Executive Summary 3
8
Benefits 8
Exclusions 9
Assumptions 9
Organizational Scope and Dependencies 11
Organizational Scope and Dependencies continued 12
Interface Scope 15
Interface OUT OF SCOPE 16
Project Control Milestones 17

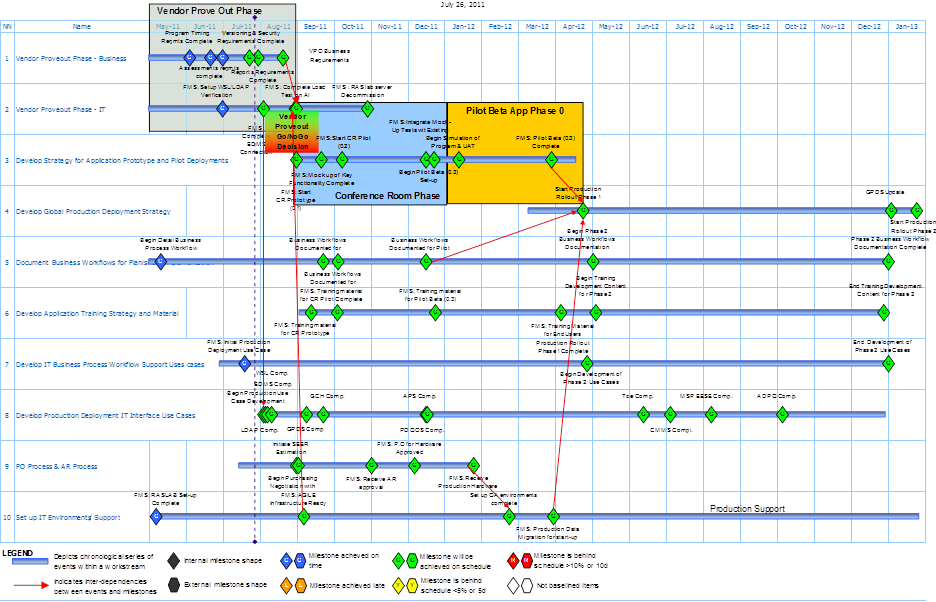

MS Project Plan 18
Logical Scope 19
Financial Scope 20
Financial & Overall Implementation Benefits Summary: 21
Approach to Measure Project Results 21
Risk Analysis 21
Critical Risk Factors 21
Other Risks 22
Related Programs and Projects 25
Project Management Approach 25
Scope Management Approach 25
Issues Management Approach 25
Risk Management Approach 26
Quality Management Approach 26
Implementation & Transition Management Approach 26
Communications Management Approach 26
Contingency Approach 27
Resource Management Approach 27
Project Organization 27
Roles and Responsibilities 27
Project Team Members 33
Charter Approval 34
Document Information 36
Revision History 37
Executive Summary
Last Updated On: | |
August 19, 2011 by Denise Austin (daustin) | |
Project Name | Project Number | |
Production Deployment of New Integrator | ITMS# 15304 | |
Program Name (if applicable) | Program Number (if applicable) | |
New Integrator – Production Deployment | | |
Project Manager | Business Project Owner | Executive Sponsor |
Adler, Mark (M.) | Habash, Richard (R.T.) | Hyde, Art (A.S.) |
Program Manager | Project Start Date | Project End Date |
Schlax, Mary (M.K.) | 06-01-2011 | 12-31-2012 |
Business Issue and / or Opportunity | ||
Better View of the Situation:
| ||
Strategic Initiative Supported | ||
Way Forward: One Ford global requirements. | ||
Project Goal | ||
To
In such a way that
So that
|
Principal Project Objectives |
The foundation will provide people and applications, authors and consumers, with a single location where Program timing & health can be accessed. Key criteria for evaluating the success of the broad objective
|
Principal Project Deliverables |
NOTE: Any additional changes will be handled through the standard change control process or will be addressed in future releases as prioritized by the business. 8. System-to-system interoperability to receive and/or send the agreed information from the following systems in scope of the project:
Any addition of new source system(s) during the course of the project will be handled through the standard Change Control process. Any new additional source systems will impact the delivery, timing, and cost. The following systems are identified to be OUT OF SCOPE and for this phase and may be implemented in a later phase, at a later time. There will be no automated functionality or exchange of data in the first phase of the Production Integrator with the following systems:
Any addition of new source system(s) during the course of the project will be handled through the standard Change Control process. Any additional source systems will impact the delivery, timing, and cost. |
Approach to Measure Project Results (Key Performance Indicator, if available) |
|
Related Projects |
None identified at this time. |
Exclusions |
1. No application customization is included in the scope of this project unless performed by Planisware. |
Assumptions |
|
|
The below group/team are the primary groups to interact for the interface systems during this project.
Group | Receives from Project | Gives to Project | Name and E-mail Address |
Executive Sponsors | Delivered solution, Bi-Weekly project status | Funding, authority | Art Hyde (ahyde) Stephen Smith (ssmith61) |
L1 Champions | Delivered solution, Bi-Weekly project status | Vision, organizational direction | Pandora Ellison (pelliso1) Bob Trecapelli (rtrecape) Kevin Timms (ktimms) Virginia Preuss (vpreuss) Richard Riff (rriff) Hau Thai-Tang (hthaitan) Raj Nair (snair) Jim Baumbick (jbaumbic) |
Business Owner / PD Operations | Delivered solution, Bi-Weekly project status | Vision, authority, business resolutions, organizational alignment, sign-off, representation to the L1 Champions & sponsors. | Rick Habash (rhabash) |
Steering Team | Delivered solution, Bi-Weekly project status | Vision, business resolutions, organizational alignment, sign-off, representation to the L1 Champions. | Richard Tilley(rtilley) Tim Veenstra (tveenstr) Tim Reid (treid) George Halow (ghalow) Imad Melki (imelki) Mary Schlax (mschlax) Steven Smith (ssmith61) |
Functional Lead SMEs / PD Operations | Delivered solution, weekly project status | Business & solution requirements, functional requirements. Business expertise. | Cindy Giacobbe (cgiacobb) Anil Manikkara (amanikka) |
Project Management Team | Delivered solution, weekly project status | Business & solution functional requirements, Business expertise, IT Support | Bill Sturgeon (wsturgeo) Ken Nguyen (knguyen3) Marty Trenkle(mtrenkl2) Brian Hawkins (bhawkin5) Thomas Hain (thain) Ernst Meijer (emeijer) Mark Adler (madler5) |
Functional / Regional SMEs Functional / Regional SMEs Continued….. | Delivered solution, Weekly project status | Business Requirements, Business expertise | Randy Miller(rmille10) Steve Taylor(stayl100) Alison Shefferly (asheffer) Bradley Bysouth (bbysouth) Uwe Kloss (ukloss1) Rodrigo Melo (rmelo6) Romel Reckerman (rreckerm) Tim King (tking11) Mike Wrublewski (mwrublew) Chris Benson ( ????? Bradley Bysouth (bbysouth) Cynthia Bertini (cbertini) Tom Bennett (tbennet1) Matthais Baumann (mbaumann) Brandon Dobbins(bdobbin4) Scott Lauffer (slauffer) Cynthia Nicholson (cnicho19) Marilynn Smith (msmith53) Justin Platt (jplatt17) Marie Mann (mmann1) Diane Traskos (dtraskos) Matthew Jefferson (mjeffer1) Gerd Mueller (gmuelle2) Graham Crawley (gcrawle1) Stuart Smith (ssmith28) Joanne Burns (jallen16) Mark Albrant (malbrant) Tricia Tygesen (ttygesen) Chris Woodhouse (cwoodhou) Kelly Plawinski (kplawins) Shashi Maire (smaire) David Laske (dlaske) John Lane (jlane15) |
IT Application Development Services | Direction, timing, plans, application requirements, business rules. | Technical expertise, SDM Documents, Project Management, estimates, design | Diane O’Mara (dfranci2) Mark Adler (madler5) Art Rice (arice) Ellen Burrows (eburrow1) |
IT Support | Direction, timing, plans, application requirements, business rules. | Technical expertise, SDM Documents, estimates, design, hardware support | PM: N.Sivasankaran(nsivasa1) PM: M.Senthilnathan (msenth13) SD: Sakthi Singaravella (ssakthi4) SD: Matt Fobear (mfobear) SA:Judith Britto (jbritt31) Reinhard Drueckes (rdruecke) |
Vendor | Business contract | Planisware software, technical support | Benoit Delhuille (bdehuil & [email protected]) |

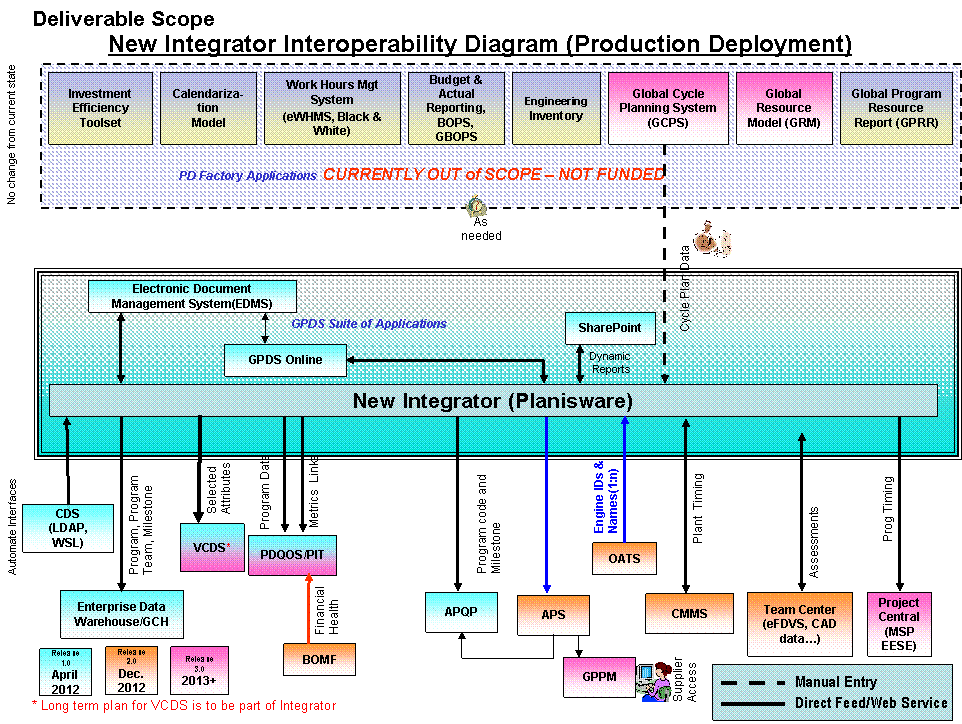

Application | | Purpose |
Global Product Development System (GPDS Online) | Using XL files, automated load. | Integrator receives process sheets and GPDS timing templates from GPDS. |
Electronic Data Management System (EDMS) | Using Ford Web service | Will be used as the document repository/management system. |
Enterprise Data Warehouse (GCH) | Automated feed. A DB view will be created in Planisware for use in MS Access to generate reports/data to be sent. | Will be sent Program, Program Team, and Milestone data from Planisware. |
PIT Dashboard | Automated feed. A DB view will be created in Planisware for use in MS Access to generate reports/data to be sent. | Will be sent Program data from Planisware. |
Advanced Product Quality Planning (APQP) | Automated feed. | Receives program timing & inputs supplier program status to APQP. Possible automated update of supplier timing from APQP into new Integrator solution. |
Project Central (MSP EESE) | Automated feed | Will be sent Electrical Program Scheduling & Timing from Planisware. |
Team Center (TCe) TCe solution (which replaces SETk, eFDVS, CeTP, eDeviation and PT Design Rules) | Automated load and feed. | Planisware will pull assessment data from TCe through a DB View. In Planisware, it will be used to calculate and update deliverable compliance. % complete for DI data can be used to generate a R/Y/G status for deliverables in Planisware. TCe will be sent Program Timing data from Planisware. |
Common Manufacturing Management Systems (CMMS) | Automated load and feed. | Planisware will pull CMMS LR-OKTB timing from CMMS VPP (Vehicle Parts Progress) module and load actual plant timing into Planisware. (Who is Master?) CMMS will be sent Program Timing from Planisware. |
Product Development Quality Operating System (PDQoS) | Automated feed | Will be sent Timing Metrics from Planisware. |
OATS | Automated feed | Will be sent Program Timing for engine & transmission data for Powertrain from Planisware. |
Application Policy Services (APS) | | Will be used to implement role based security for Ford employees and Suppliers. Will be sent Program code and Milestone data from Planisware. This data will then be altered and passed from APS to GPPM and to APQP. |
Lightweight Directory Access Protocol (LDAP) (FDS) | | Will be used to implement Web Single Logon (WSL) using APS (Application Policy Services) for user access to Planisware and implement role based security. |
| | |
| | |
| | |
Interface OUT OF SCOPE |
The following systems are identified to be OUT OF SCOPE and NOT FUNDED for this phase and may be implemented in a later phase, at a later time. There will be no automated functionality or exchange of data in the first phase of the Production Integrator with the following systems:
Application | Purpose |
PD Factory Applications: - Investment Efficiency Toolset - Calendarization Model - Work Hours Management system (eWHMS, Black & White) - Budget & Actual Reporting (BOPS)(GBOPS) - Engineering Inventory - Global Cycle Planning System (GCPS) - input program timing, vehicle volume, powertrain lineup, global cycle plans, program information. - Global Resource Management (GRM) – determine sharing program timing and resource requirements. - Global Program Resource Report (GPRR) - Advanced Vehicle Bill of material (AVBOM) | |
Vehicle Class Data Set (VCDS) | Apply agreed approach to use VCDS data as applicable to new solution. |
PD QOS | Complete integration and reporting of health chart metrics at the functional and vehicle program level is out of scope. Only receiving timing metrics is in scope. |
Allow suppliers to use Integrator directly (CDSID) to complete assessments, usually on a monthly basis. | |
Project Control Milestones |
Milestone | Date |
Project Start | 5/2/11 |
Vendor Prove Out – GO.NO Decision | 8/15/11 |
SEER Estimate Complete | 8/23/11 |
| |
| |
Project Completion | |
This Timing plan will continually be updated. For current timing plan refer to latest Steering Committee Status Meeting Minutes
+
Total Project Spending Including VPO
2011 2012 2013 Budgetary Estimate Budgetary Estimate Labor – Ford $ 346,000 Labor – non-Ford $ Travel $ 66,000 Hardware $ 32,000 Software Licenses Outside Services $ 80,300 Training $ TBD OTHER (Business Resource) $ 72,000 Forecast $ 596,300* $3,100,000 $500,000_ 2011 Budget $ 580,000*This forecast may not reflect all the costs for the planned conference room prototype (phase 0.1), a pilot with additional functionality (phase 0.2) and the beginning of the production-like pilot simulating the life cycle of a program in the development environment. (phase 0.3) Current assumption is this will be contained within budget.
Financial & Overall Implementation Benefits Summary: |
Overall reduction in IT custom enhancement work to ensure compliance with GPDS changes and business requests: $288K Annually
$4.3M Annual save across Product Development and Quality specifically with PMT and PD factory engineering efficiencies as they track and deliver Global Product Development System (GPDS). (See attached matrix for details).
Supports D&R council and PMT Effectiveness QPIP efforts to improve Engineering Productivity through reduction in redundant data entry (Robust FDJ etc.).
Eliminates hidden factory reporting outside of Integrator Supports global program efforts to manage status and reporting efficiently.
Opportunity to eliminate application costs associated with GCPS (Global Cycle Planning System) as well as GRM (Global Resource Management) but leverage a single toolset for all functions.
Business Owner signoff.
Application control review signoff from the SCC/ICC team
Customization of reports and Integration systems web services customization for the production launch
# | Critical Risk Factor | Mitigation Strategy |
1 | Availability of SMEs across CBGs | |
2 | Availability of Integration Team resources | |
3 | For Reporting, Planisware reporting may not meet our requirements. Setting up the VPP timing with Benoit in Planisware was “pretty rough”. We may need to additionally look at Congo’s and/or Web Focus for reporting. Planisware is working on a new BI module that is scheduled for release in early 2012. | set a go/no go date in the VPO (or one of the pilots) for using Planisware for reporting. |
The Risks and mitigation strategies will be maintained in Clarity. Additional risks may be identified during the Project progress at which time they will be added to the Clarity tool and managed
Project Risks | ||||||||||||||||||||||||||||||||||||||||
|
Project Risks (Cont'd)
Risk Category / Risk Description | |
Unclear Objectives and Requirements | |
| The support model between the business and IT is not agreed on. Need agreement on development and on-going support to get an accurate deployment cost estimate |
Resource availability | |
| Availability of other application teams during the implementation of project (TCe, EDMS, SharePoint) may not be able to make changes to meet our production launch timing. |
| Resources to develop/execute applications training have not been identified. |
Software | |
| Initial feedback and training indicate the report capabilities within Planisware may not be robust enough to support Ford's requirements (VPP,etc.) If Planisware reporting tool does not cover the business’s needs, other tools will need to be evaluated (such as Cognos or WebFocus). This will result in a delay in timing and an increase in the project cost. |
| Initial feedback from tool training and Airbus indicate more emphasis may be needed to validate UI with end users early on to ensure the tool is simple to use. |
Sponsorship, Governance | |
| Few of the L2 steering members have been participating in the governance meetings adding risk to the overall acceptance of the project. |
| Need to ensure functional engineering organizations are aware of project direction, improvements and understand what their role will be in the future (i.e. feedback from discussion with Electrical - Sandra Skinner). |
| Need to ensure functional engineering organizations are aware of the product. |
Supportability, Maintainability | |
| Airbus feedback indicated low satisfaction with Planisware's support post deployment. Slow response with continued negotiations to resolve issues, along with no commitment on release dates. |
| Planisware is scheduled to launch a BI Module in early 2012. Need to determine what functionality will be available with new Module and determine what capabilities can wait. |
Testing and Quality Assurance | |
| Planisware Current Database Training Setup is done in Oracle 10 version. For Load testing in SQL DB server need to install Planisware Component in SQL server. |
Program/Project | Dependency | Coordination Strategy |
| | |
| | |
| | |
| | |
Scope changes will be managed through a formal change management process. When a change is identified a Request for Scope Change will be completed and submitted to the Project Manager. The Project Manager will log and track the change in the Project Scope Change log and then review all requests with the Project Sponsor(s). It will be their responsibility to 'accept' the change and assign an individual(s) to investigate the impact, or to 'reject' or 'defer' the change.
The Project Sponsor(s) will 'approve' all Scope Changes. Changes to the original Project Charter will be documented in the Project Charter Addendum by the Project Manager and approved by the Project Sponsor(s).
Scope changes will be reviewed with the Project Sponsor on a weekly basis and will also be reviewed with the Project Team during the Weekly Project Status Review Meetings.
Any member of the Project Management Organization and the Project Team may identify a Project Issue to the Project Manager. It will then be the responsibility of the Project Manager, and when applicable, the Project Sponsor(s) to validate the issue and determine its Severity. It will then be their responsibility to assign an individual(s) to investigate and recommend a solution, and subsequently to assign an individual(s) to resolve. Once accepted as an issue, the Project Manager will be responsible for logging and tracking issues in the Project Issues log.
Issues will be reviewed with the Project Sponsor(s) on a bi-weekly basis and will also be reviewed by the Project Team during the Weekly Status Review Meetings.
It will be the responsibility of the Project Manager to identify and manage the project risks with assistance, where appropriate, by the Project Sponsor(s). All project risks will be documented in the Project Risk Management Log.
The Project Manager will report immediately to the Project Sponsor(s), in writing, changes to the status of High Risk items. These would include conditions where the Mitigation Strategy is not working, an existing Risk has changed to a 'high' Severity, or a new 'high' Severity Risk is identified.
Risks will be re-evaluated as part of the Project Review process, or in the event of a change, to the Project Management Organization.
The Project Manager will be responsible for ensuring that the project adheres to process standards, which will ensure high-quality, timely completion, as well as, compliance with Corporate standards, including infrastructure and security. The projects will follow IT Quality Standards, which include the completion of independent Quality Reviews at major project milestones. The results of the reviews will be reported to the Sponsor as they occur
The Project Manager will be responsible for developing and communicating detailed plans for implementing and transitioning project deliverables to customers and support functions. Those plans will be made available to the Sponsor(s) at Final Charter Review.
Status Reviews
The Project Manager will conduct weekly Project Review Meetings with the Project Team. The Project Manager will be responsible for setting the agenda, preparing the items for review, conducting the meeting and documenting the results. During these meetings project schedule and milestones, risk, scope changes, issues and budget will be reviewed. Progress on assigned action items will be reported.
Project Reviews
The Project Manager will conduct bi-weekly Review Meetings with the Project Sponsor(s). The Project Manager will be responsible for setting the agenda, preparing the items for review, conducting the meeting and documenting the results with support from Business Lead and Core Team. During these meetings project schedule and milestones, risks, scope changes, issues and budget will be reviewed. Overall health will be assessed and project continuation will be approved.
Other Communications
The Project Manager will develop a Complete Communications Plan and make that plan available to the Sponsor at Charter signing.
TBD
Resource Management ApproachStandard ADS Resource management approach will be followed. Both ADS NA and AP resources will be utilized to deliver this project.
Role | Description | Responsibility (Name & CDS ID) |
Sponsor |
| Hyde, Art (A.S.) Smith, Stephen (R.) |
GPDS Integrator L1 |
| Pandora Ellison Art Hyde Bob Trecapelli Frank Davis Richard Riff Kevin Timms Stephen Smith Mary Schlax Hau Thai-Tang |
GPDS Integrator L2 Steering Team |
| Art Hyde Rick Habash Richard Tilley Tim Reid Stephen Smith Mary Schlax Tim Veenstra George Halow Imad Melki Greg Reynolds |
GPDS Integrator L3 Program Management Team |
| Rick Habash, Cindy Giacobbe Randy Miller, Bill Sturgeon, Alison Shefferly /Clem Valot Romel Reckerman Marty Trenkle Thomas Hain, Brian Hawkins Bradley Bysouth |
Project Customer |
| Habash, Richard (R.T.) (rhabash) |
IT Project Owner |
| O’Mara, Diane (dfranci2) |
PTG Manager |
| Giacobbe, Cindy (C.) (cgiacobb) Manikkara, Anil (K.) (amanikka) |
Project Manager |
Note: The Project Manager may assist in the creation of the project deliverables, but this is a secondary role to that of Project Manager and must be treated as such. | Adler, Mark (M.) (madler5) |
Functional Lead SMEs |
| Sturgeon, Bill (W.E.) (wsturgeo) Nguyen, Ken (knguyen3) Thomas Hain Brian Hawkins |
Extended Team SMEs |
| Meijer, Ernst (EJ) (emeijer) |
Business Analyst |
| Burrows, Ellen (eburrow1) Rice, Arthur (arice) |
Team member |
| Fobear, Matt (MJ) (mfobear) Senthilnathan (M) (msenth13) Singaravelu, Sakthivel (S.) (SSAKTHI4) |
Vendor |
| Planisware Delhuille, Benoit (B.) (bdelhuil) |
Role | Description / Skills | Resource Allocation (# FTE) | Responsibility (Name & CDS ID) |
IT Program Manager Production | | 1 | Diane O’Mara (dfranci2) |
IT Program Manager(VPO) | | 0.25 | Sivasankaran (nsivasa1) |
IT Project Manager Production | | 1 | Mark Adler (madler5) |
IT Project Manager(VPO) | | 0.75 | Senthilnathan. M (msenth13) |
IT Business Analysts | | 2 | Ellen Burrows (eburrow1) Art Rice (arice) |
IT Developer | | 1 | Singaravel Sakthi (SSAKTHI4) |
IT Solutions Architect | | .25 | Rajagopal Mahesh (rmahes1) |
IT Solutions Architect | | .25 | Judith Britto (jbritt31) |
Approval of the Charter | ||||
By signing this Control Sheet, I confirm that I approve Version.... of the Initial / Project Charter for the New Integrator Production Deployment Project. This means that you want the New Integrator Production Deployment Project to proceed and allow the Application Development organization resource to continue work toward meeting the deliverables described in this document. | ||||
Name | Role on the Project | Signature | Approved Y / N (See below) | Date |
Hyde, Art (A.S.) | Sponsor – GPDS | | Y | 9/26/11 |
Smith, Stephen (R.) | Sponsor – Quality IT | | Y | 7/06/11 |
Habash, Richard (R.T.) | Business Owner | | Y | 7/15/11 |
Tilley, Richard (R.C.) | Chief Program Manager | | Y | 9/26/11 |
Reid, Timothy (T.) | Chief Program Manager APA | | Y (Cond) | 7/13/11 |
Veenstra, Tim (T.W.) | Chief Program Manager FNA | | Y | 7/05/11 |
Halow, George (G.F.) | Body Integration Chief | | Y | 7/28/11 |
Melki, Imad (I.E.) | Powertrain | | Y (Cond) | 7/14/11 |
Schlax, Mary (M.K.) | IT Program Manager | | Y | 7/15/11 |
O’Mara, Diane (M.) | IT Project Owner | | Y | 7/15/11 |
Giacobbe, Cindy (C.) | IT Portfolio Manager, Quality | | Y | 7/15/11 |
Adler, Mark (M.) | IT Project Manager | | Y | 7/15/11 |
Conditions | | | | |
Acceptance is conditional on the following: | ||||
|
Information Required | Name |
File Name | 200_Project_Charter_Prod Integrator_1.0.doc |
Original Author(s): Version 1.0 – Initial Charter | Denise Austin (daustin) |
Current Revision Author(s): Version 1.01 | Mark Adler (madler5) |
Current Revision Author: Version 1.02 - 1.04 | Denise Austin (daustin) |
Charter Session Participants | Global Steering Committee |
Current Revision Author v.1.05 | Mark Adler (madler5) |
| |
| |
| |
| |
| |
| |
Version | Date | Author(s) | Revision Notes |
1.01 | 06-JUL-2011 | Mark Adler | Incorporated Suggestions from Stephen Smith |
1.02 | 06-JUL-2011 | Denise Austin | Updated Organizational Scope & Dependencies and Interface Scope |
1.03 | 28-JUL-2011 | Denise Austin | Updated to reflect changes to the PowerPoint Charter Overview document from 7-18-11. |
1.04 | 10-Aug-11 | Denise Austin | Updated to reflect changes to the PowerPoint Charter Overview document from 8-1-11. |
1.05 | 22-Nov-11 | Mark Adler | Final synchronization will approved Powerpoint Charter Overview Document from 9-26-11 |
Originator: <Prod Integrator>/<daustin> Page 37 of 37 Date Issued: <June 14, 2011>
xz9sjci4e0.doc Date Revised: <November 22,2011>
GIS1 Item Number: 17.05 Retention Start Date:
GIS2 Classification: Proprietary
